Skip to main content

The schedule list

Required permission:
  • View Schedule (Routing Schedule)
Open Planning › Schedule and click the Routing tab. The list follows the hub picker in the top bar, so it shows the routing schedules of the hub you are working in.

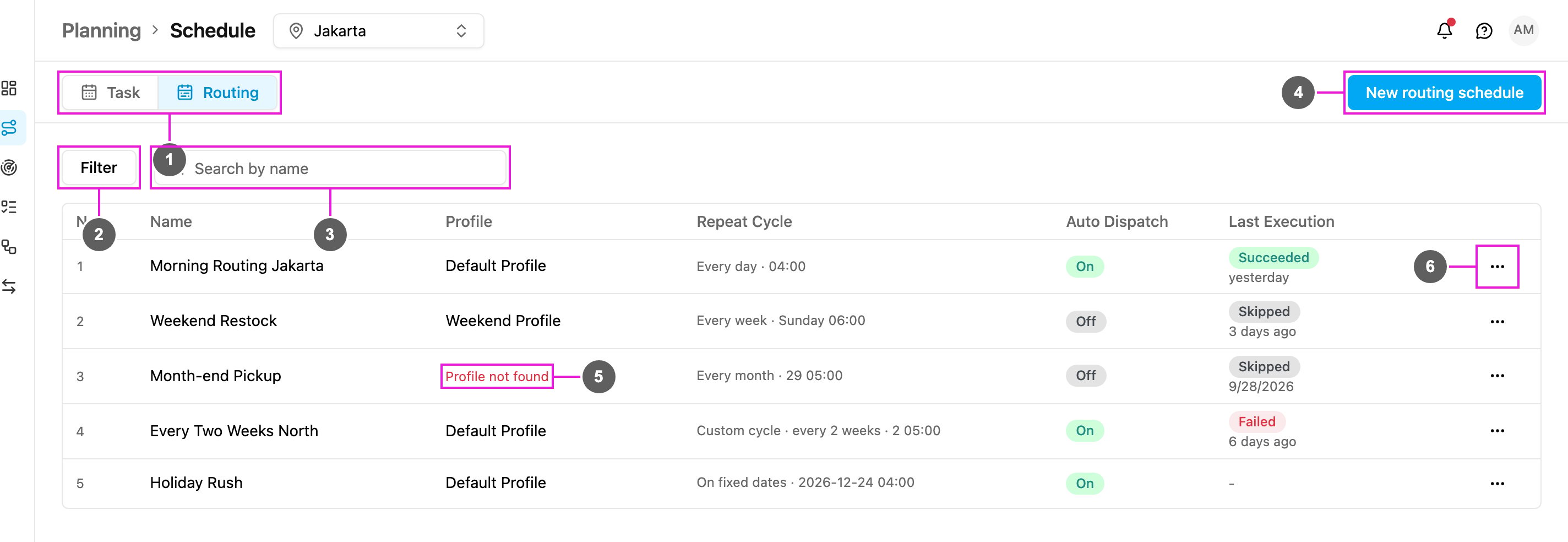

Routing schedule list
  1. Task / Routing: switch between task schedules and routing schedules.
  2. Filter: show only schedules whose last run has a given status. Click Reset all to clear it.
  3. Search by name: find a schedule by part of its name. The search and the filter work together.
  4. New routing schedule: create a schedule. See Creating a Routing Schedule.
  5. Profile not found: the profile this schedule used has been deleted. The schedule is skipped on every run until you edit it and choose a profile that exists.
  6. Routing schedule actions: View, Edit or Delete the schedule.
The table has these columns: The count above the table shows how many schedules there are, or how many match your filters.

Last execution

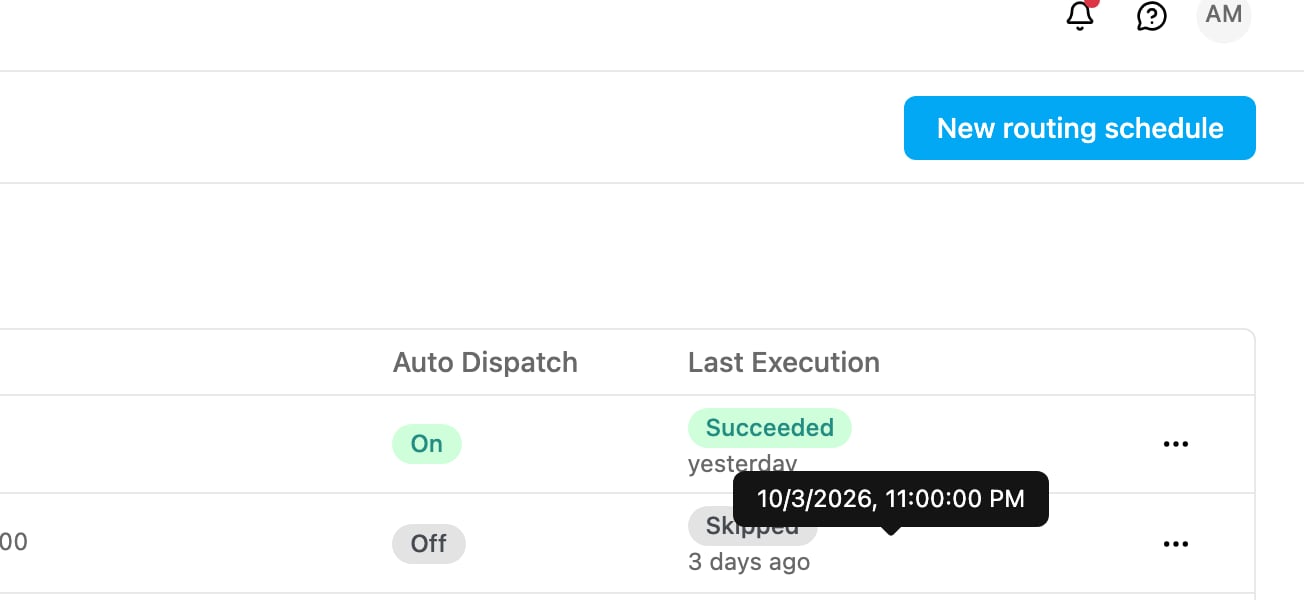

This is the column to read when a schedule isn’t producing what you expect. It shows a badge for the last run. Hover it to see the exact time of that run.
Last execution
A schedule that hasn’t run yet shows Not run yet.
The list shows only the most recent run. To see everything a schedule has produced over time, open Planning › Routing › Result, where every scheduled result is listed with the others.

View a schedule

Choose View from the row menu to open the schedule’s detail.

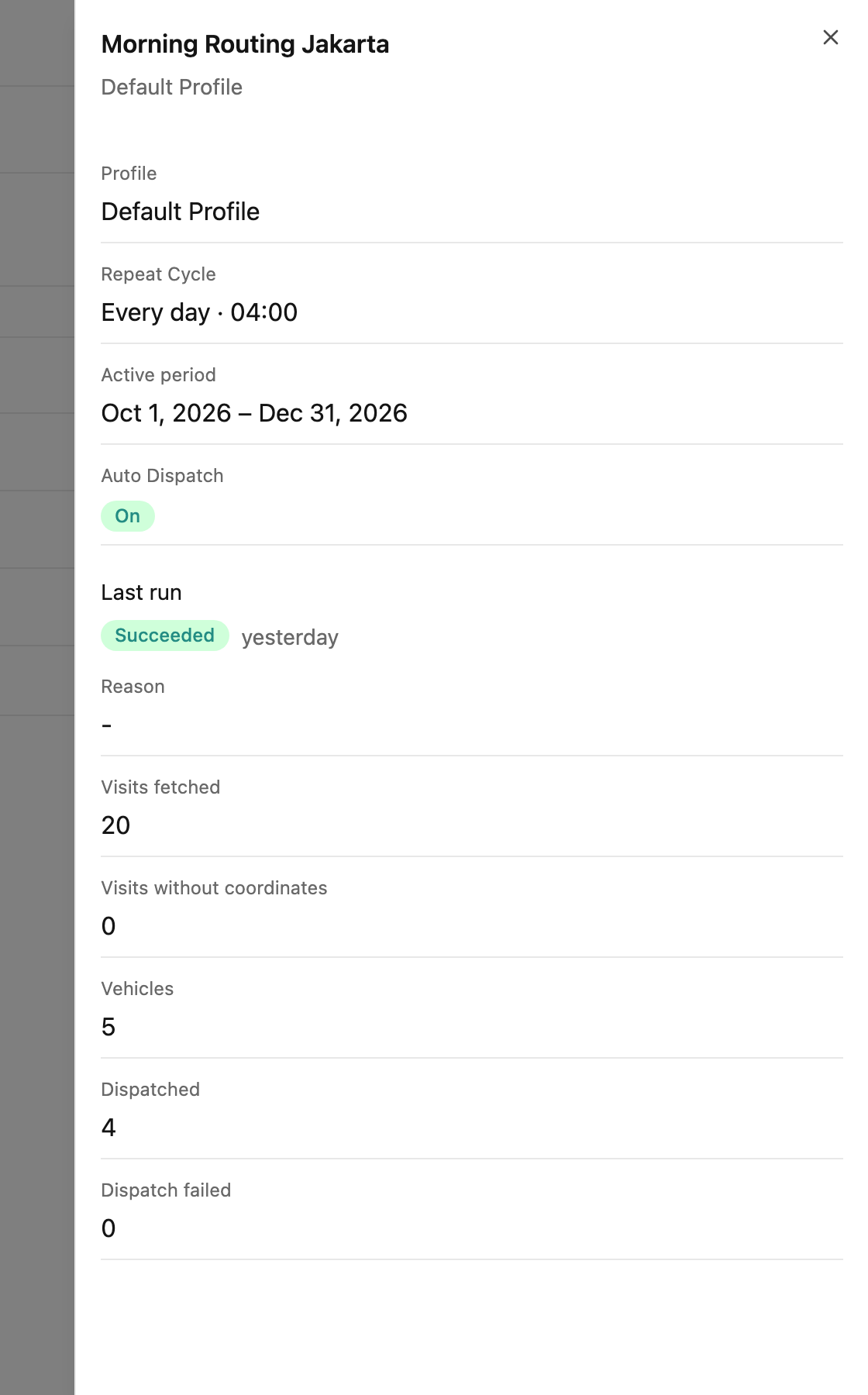

Routing schedule detail

Why a run was skipped or failed

When a run can’t go ahead, it is skipped instead of left half-finished, and the reason is recorded in Reason. Two reasons show as Failed, because the run did start:
A skipped or failed run is never retried automatically. The schedule simply runs again at its next scheduled time.

Edit a schedule

Required permission:
  • View Schedule (Routing Schedule)
  • Edit Schedule (Routing Schedule)
Choose Edit from the row menu. The same form opens with the current values, titled Edit routing schedule. Every field can be changed, including the profile. Click Save. Changes take effect from the next run. A run already in progress is not affected.
You rarely need to edit a schedule just because the routing must change. Vehicles, constraints and optimization settings live on the configuration profile, and each run reads the profile fresh, so editing the profile is usually enough.

Delete a schedule

Required permission:
  • View Schedule (Routing Schedule)
  • Delete Schedule (Routing Schedule)
Choose Delete from the row menu. The app asks for confirmation.

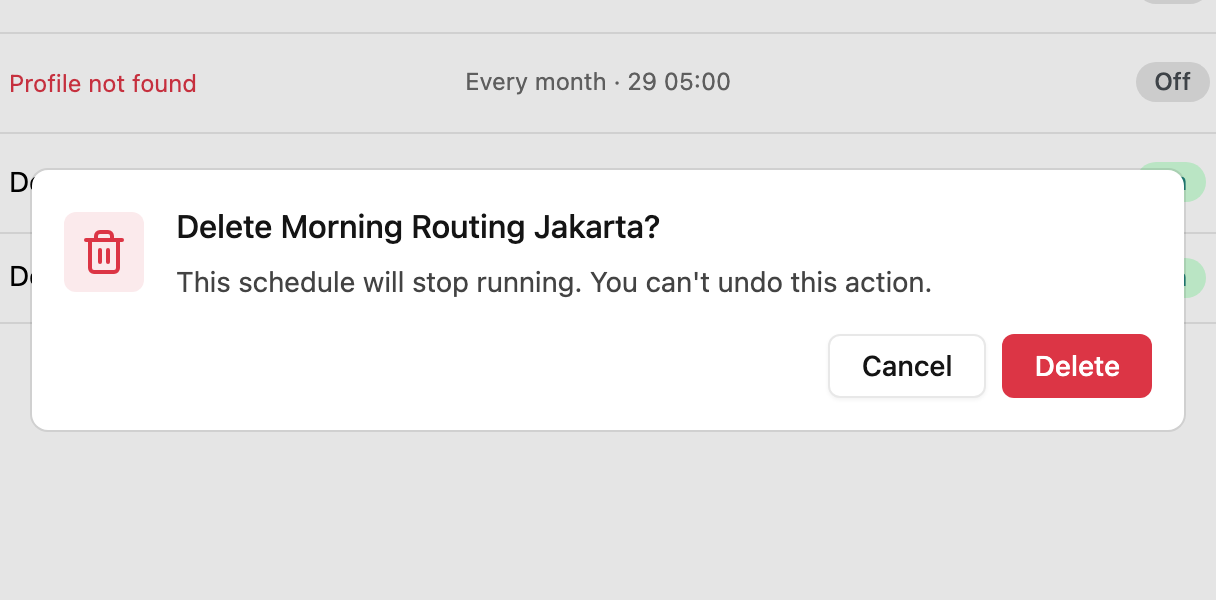

Delete routing schedule
Click Delete to confirm. The schedule stops running at once and disappears from the list. Results it produced earlier are not deleted: they stay in Result and can still be opened and dispatched.
Deleting is the way to stop a schedule; there is no on/off switch. If you might want it back later, note its profile, name and repeat cycle before deleting it.
